Dual Occupancy Australia 2026: The Complete Guide to Subdivision, DA vs CDC and Real Costs

In 2026, more Australian homeowners are turning their backyards into income-generating assets. Dual occupancy Australia 2026 has become one of the most searched property strategies — and for good reason. With housing supply shortfalls across NSW, Victoria, and Queensland, dual occupancy delivers two dwellings on one lot, often for a fraction of the cost of buying a second property.

Furthermore, state governments have progressively relaxed planning rules. Consequently, pathways like the CDC (Complying Development Certificate) make approvals faster and more predictable than ever. This guide covers everything: what dual occupancy actually means, battleaxe subdivision rules, CDC versus DA, state-by-state regulations, real cost breakdowns, and profit scenarios.

Important note: This guide focuses primarily on New South Wales (NSW) planning rules, which represent the most active dual occupancy market in Australia. Planning controls in Victoria, Queensland, South Australia, and Western Australia differ significantly by state and local council. Always verify your specific council’s requirements before proceeding with any development.

What Is Dual Occupancy? The Complete Definition

Dual occupancy means building or converting a single residential lot so that it contains exactly two separate dwellings. Both dwellings share the same land title — they are not subdivided into individual lots unless a torrens or strata subdivision follows. In most Australian states, dual occupancy is subject to local environment plans (LEPs) and state-level residential codes.

Additionally, dual occupancy takes two common forms. The first is an attached dual occupancy — two dwellings joined by a shared wall, similar to a duplex. The second is a detached dual occupancy — two completely separate homes on the one block. Notably, the detached form requires sufficient lot size and setback compliance, which varies significantly by council area.

Aerial view of Australian suburb with dual occupancy development potential
Western Sydney suburbs showing residential density growth in 2026

Moreover, recent low-rise medium density reforms in NSW have expanded dual occupancy eligibility to most residential zones. Together, these policy changes mean that properties previously too small or too tightly zoned for dual occupancy are now viable development sites. Overall, the opportunity is significant — but success depends on understanding the rules.

Sydney residential construction site — NSW dual occupancy development 2026
Residential construction activity in Sydney — demand for dual occupancy approvals is at a record high across Western Sydney and established suburbs in 2026

Battleaxe Subdivision — How to Add a Second Lot Behind Your Home

A battleaxe block is a rear lot accessed via a narrow driveway — typically 3 to 4 metres wide — running between the front property and the street. The term comes from the shape: a long thin handle (the driveway) leading to a wider rectangular head (the rear block). In practice, battleaxe subdivisions are one of the most common strategies for dual occupancy in established Australian suburbs.

However, battleaxe blocks are not available everywhere. Most councils require a minimum driveway width — commonly 3 metres clear, and sometimes 4 metres for fire truck access in longer driveways. Additionally, the rear lot must meet minimum lot size requirements, which in NSW typically sit at 300sqm after subdivision for CDC-eligible sites. In Victoria and Queensland, minimums vary by zone and council.

Crucially, the driveway area (the “handle”) is usually included in the total site area for planning calculations. Consequently, a property might appear large enough on paper but fail after the driveway area is deducted. Therefore, always engage a surveyor or town planner to assess battleaxe feasibility before committing to a purchase or development.

Narrow side access driveway for battleaxe subdivision in Australian suburb
A typical battleaxe driveway — the access “handle” must be at least 3.0 metres clear width to satisfy most NSW council requirements
Trap #1 — Driveway width: many councils in 2026 require 3.5 metres minimum clear access for emergency vehicles. If your side clearance is less than 3.0 metres, your battleaxe subdivision is not feasible regardless of block size.

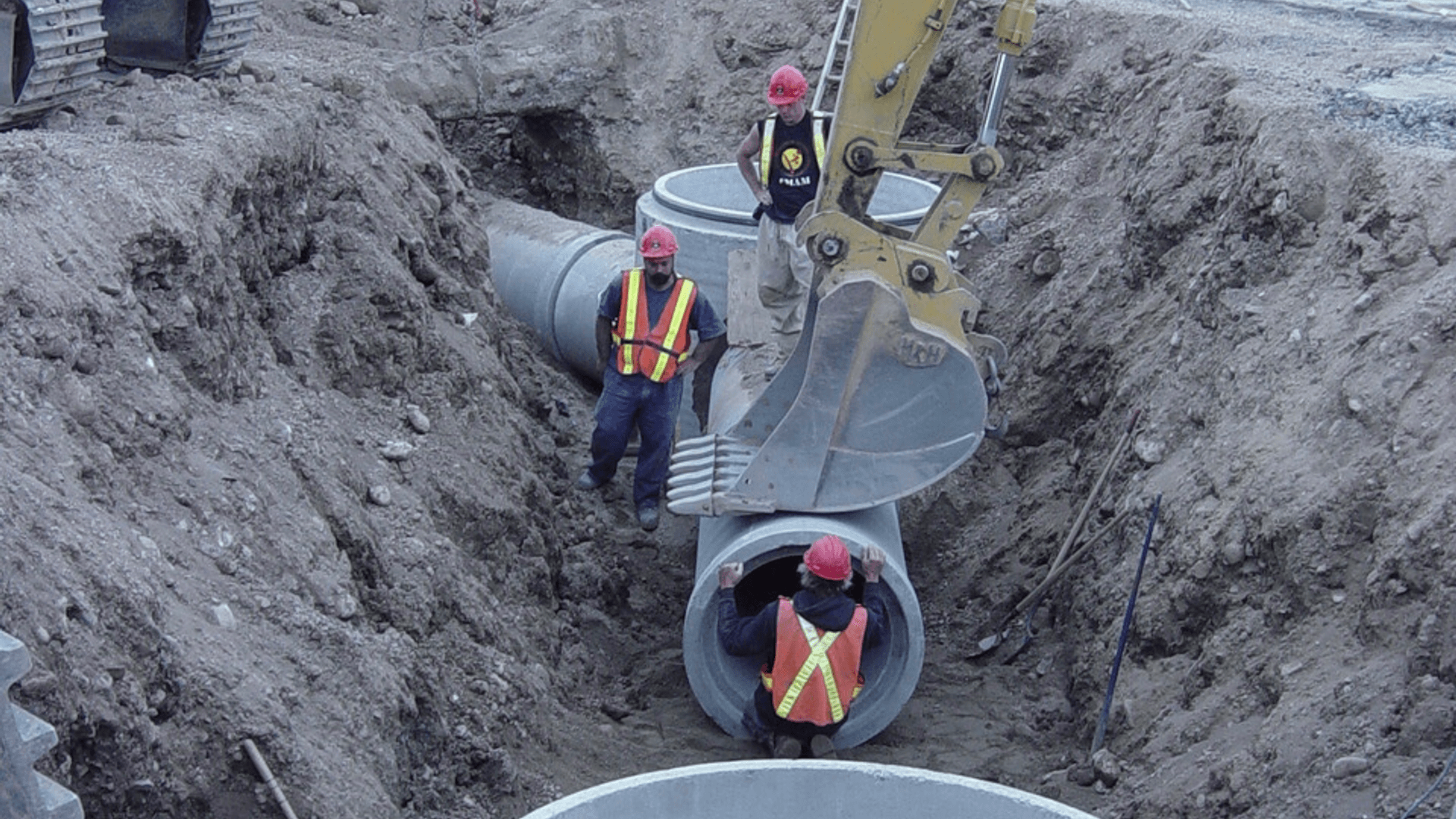

Underground sewer pipe trench construction — dual occupancy site services
Trap #2 — Invisible pipes: always buy a sewer and stormwater diagram from your water authority before spending money on design. A council trunk main crossing your rear yard makes building over it illegal.

CDC vs DA — Choosing the Right Approval Path

For most dual occupancy projects in 2026, the first big decision is whether to pursue a Complying Development Certificate (CDC) or a Development Application (DA). In NSW, a CDC is processed by a private certifier — typically in 20 business days or less. By contrast, a DA goes to council and commonly takes 6 to 18 months, sometimes longer for complex sites.

However, CDC eligibility is strict. Your property must be in an eligible zone, meet minimum lot sizes, satisfy setback rules from all boundaries, and comply with height limits — all without variation. Importantly, if any single rule is not met — even by a centimetre — you cannot use the CDC pathway. In that case, a DA is the only option.

The DA pathway, meanwhile, offers more flexibility. A council assessment officer can consider site-specific circumstances and may grant exceptions to standard controls. As a result, irregular lots, heritage-adjacent sites, and steep terrain are often better suited to DA approval. Indeed, the longer timeline is often worth it for complex projects with higher profit margins.

CDCDA
Approval time~20 business days6–18 months
Processed byPrivate certifierLocal council
FlexibilityLow — strict compliance onlyHigh — discretionary assessment
Fees$3,000–$8,000$10,000–$30,000
RiskLow (if eligible)Medium–high
Best forStandard compliant sitesComplex or non-standard sites

Can I Do a Duplex Subdivision Under CDC?

Yes — but only if your site meets every CDC eligibility requirement without any variation. In NSW, the Low Rise Housing Diversity Code allows dual occupancy via CDC where the lot is in an eligible zone, meets minimum lot size (typically 400sqm for detached dual occupancy), satisfies all setbacks, and complies with height limits. Importantly, if even one rule is not met, you must pursue a DA instead. There is no partial CDC compliance — it is all or nothing.

Notably, the growth along Western Sydney’s major corridors has generated significant dual occupancy demand. Leppington’s development pipeline for 2026 illustrates how greenfield subdivision and dual occupancy strategies are converging across the South West Growth Area, creating new opportunities for investors and homeowners alike.

State-by-State Rules for Dual Occupancy Australia 2026

Rules for dual occupancy differ significantly across states. In NSW, the Low Rise Medium Density Housing Code allows complying development for dual occupancy in most residential zones. Additionally, the minimum lot size for a detached dual occupancy CDC is 400sqm in standard residential zones. Councils must comply with state-level housing policies, reducing local variation compared to previous years.

In Victoria, dual occupancy is permitted under ResCode in most General Residential Zones. Furthermore, council overlays — such as neighbourhood character or heritage overlays — can restrict design options even when underlying zoning permits it. Therefore, always check both the zone and any applicable overlays before beginning design work.

Modern dual occupancy townhouses in Melbourne Victoria
Dual occupancy in Victoria is governed by ResCode — modern townhouse outcomes are achievable across most General Residential Zones

In Queensland, the rules depend heavily on local planning schemes. Many councils allow dual occupancy in Low Density Residential and Character Residential zones, but design requirements vary. As a result, a dual occupancy approved in Brisbane City may not meet the same requirements as one in Moreton Bay or Gold Coast. Engaging a local town planner is particularly important in Queensland.

Local council building NSW — dual occupancy DA approval
Local councils across NSW, Victoria and Queensland each apply different rules — check your specific council’s planning scheme before starting design

Real Cost Breakdown — What Dual Occupancy Actually Costs in 2026

Understanding costs is critical before committing to any dual occupancy project. In NSW and Victoria, construction costs for a new detached dual occupancy typically range from $2,800 to $3,500 per square metre for a project builder, and up to $4,500 per square metre for custom builders. Consequently, a 200sqm second dwelling costs roughly $560,000 to $900,000 to build, before accounting for site works.

Additionally, site-related costs add significantly to the total. These commonly include: demolition of existing structures ($15,000–$50,000), site levelling and excavation ($20,000–$80,000), retaining walls ($20,000–$150,000 depending on slope), services connections — sewer, water, power, gas ($15,000–$40,000), and driveway and landscaping ($20,000–$60,000).

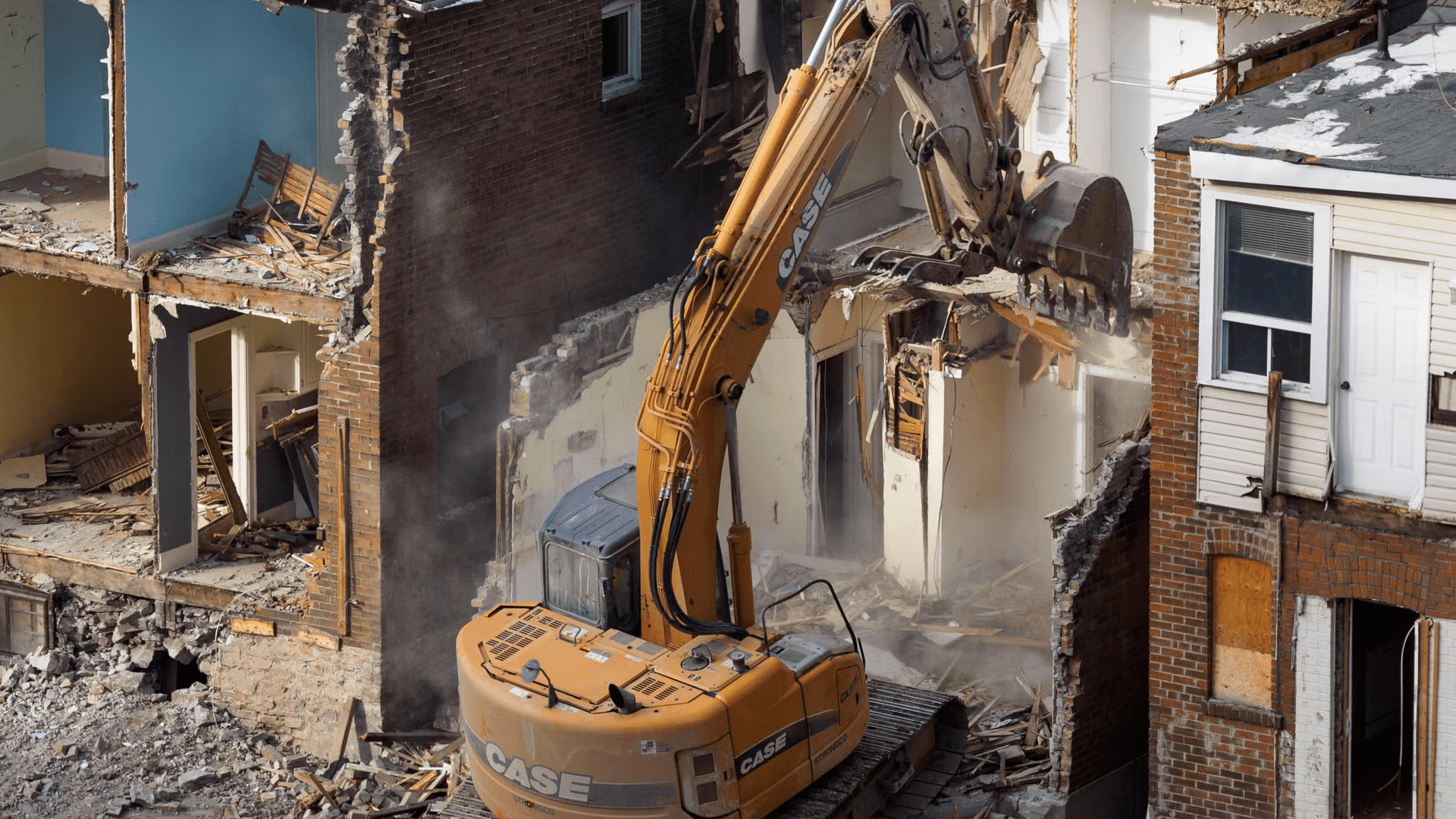

House demolition excavator on dual occupancy development site in Australia
Demolition of existing structures is typically the first major cost on a dual occupancy site — budget $15,000–$50,000 depending on structure size

Approval costs must also be factored in. A CDC application via a private certifier commonly costs $3,000–$8,000 in fees. A DA to council can cost $10,000–$30,000 in fees, contributions, and consultant costs. Moreover, design and engineering fees — architect, structural engineer, hydraulic engineer — add a further $20,000–$60,000 depending on project complexity.

How Much Does a Dual Occupancy Subdivision Cost in NSW?

Cost ItemTypical Range (NSW 2026)
Demolition$15,000–$50,000
Site levelling & excavation$20,000–$80,000
Retaining walls$20,000–$150,000
Services (sewer, water, power)$15,000–$40,000
Driveway & landscaping$20,000–$60,000
Design & engineering fees$25,000–$65,000
CDC fees$3,000–$8,000
DA fees (if applicable)$10,000–$30,000
Pure build cost (150–200sqm)$560,000–$900,000
Total project estimate$700,000–$1,300,000+
Watch our full dual occupancy guide — CDC vs DA, battleaxe subdivision, and profit calculations explained

Dual Occupancy Profit Calculator — Can You Actually Make Money?

The profit potential from dual occupancy depends on your entry price, build cost, and local market rents or sale prices. Overall, the three main profit scenarios are: hold both dwellings for rental income, sell the second dwelling after strata subdivision, or sell the entire site with two completed dwellings to a developer or investor.

For a rental income scenario: in Western Sydney, a new 3-bedroom second dwelling typically rents for $580–$750 per week in 2026. At $650 per week, that is $33,800 annual rent. Against a build cost of $700,000 (inclusive of site works), the gross rental yield is approximately 4.8%. Furthermore, retaining the existing front home for rental adds another $550–$700 per week, making the combined yield on total project cost highly competitive.

For the sale scenario: if the second dwelling can be strata subdivided and sold separately, comparable new 3-bedroom homes in outer Western Sydney sell for $900,000–$1,100,000 in 2026. Consequently, a project with a total cost of $1,500,000 (land plus build) and a dual sale outcome of $2,200,000 generates a gross margin of approximately $700,000 before tax and agent fees.

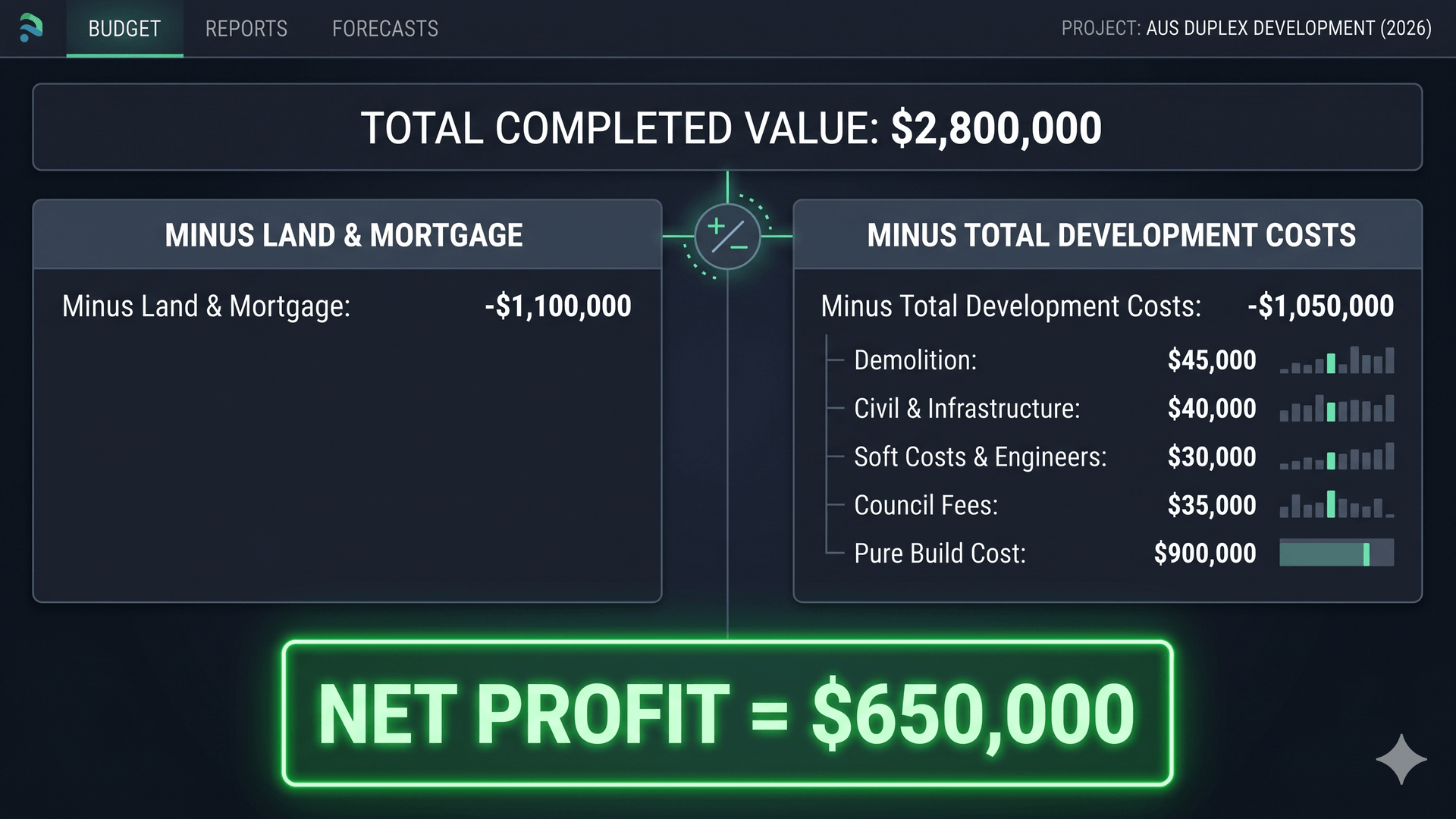

Dual occupancy Australia 2026 cost and profit breakdown infographic — $2.8M completed value, $650K net profit
Sample dual occupancy development: $1.1M land & mortgage + $1.05M build costs = $650K net profit on $2.8M completed value

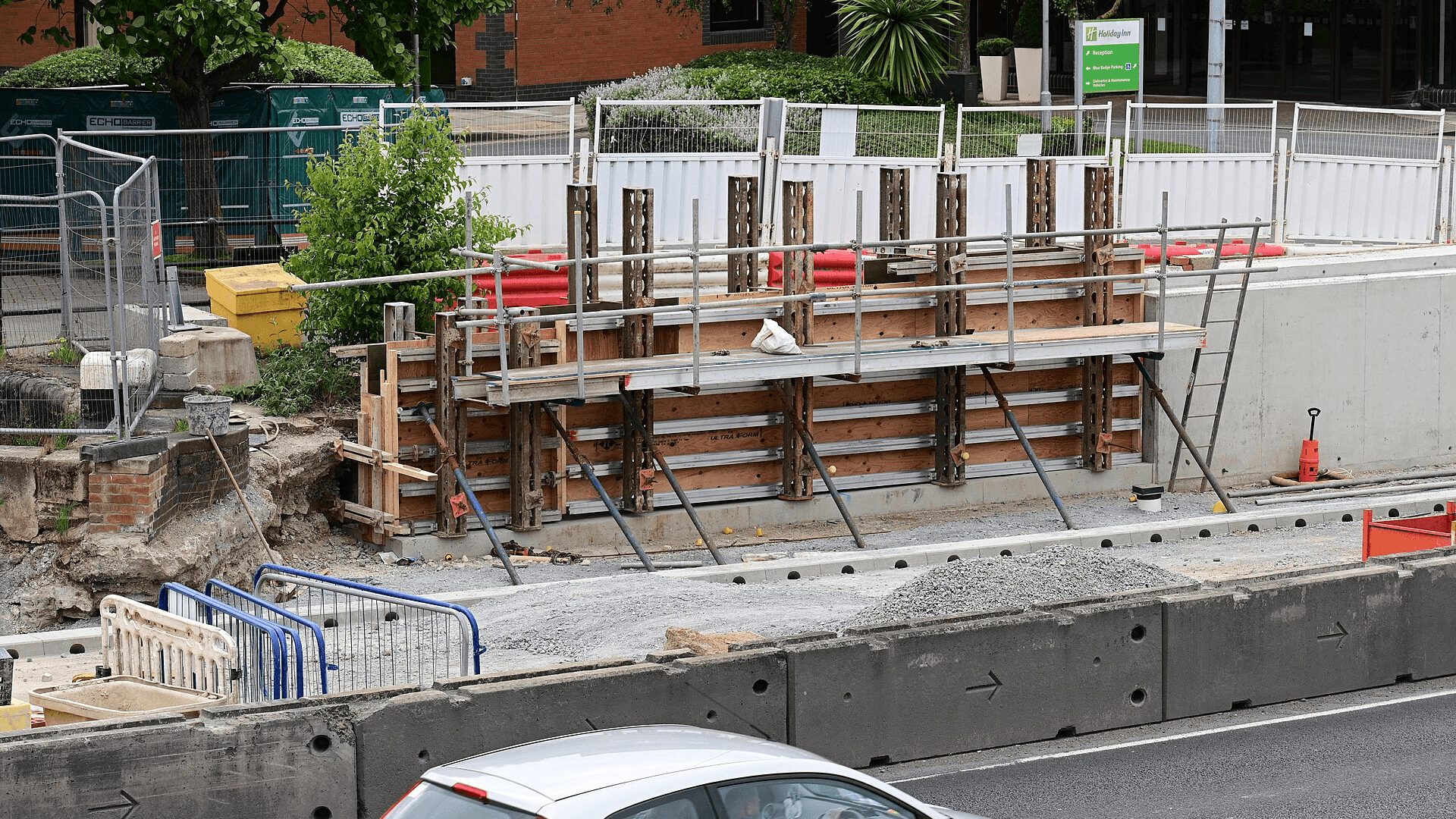

Retaining wall construction for dual occupancy battleaxe development
Retaining wall construction is a common cost on sloped dual occupancy sites in NSW and Victoria

Realistic Timeline — From Concept to Tenants

Many first-time dual occupancy developers underestimate how long the process takes. In reality, even a straightforward CDC project in NSW takes 12 to 18 months from initial feasibility to the first tenant moving in. A DA project on a complex site can take 24 to 36 months. Understanding the timeline prevents financial stress and poor planning decisions.

The typical CDC timeline runs as follows: feasibility and design (2–3 months), CDC application and approval (1–2 months), construction tender and contract (1–2 months), construction itself (8–12 months), and fit-out, landscaping, and final inspection (1–2 months). In addition, strata subdivision — if planned — adds another 3–6 months after construction completion.

Importantly, Western Sydney’s ongoing infrastructure expansion is compressing timelines in some areas. The Western Sydney Airport precinct has accelerated builder availability and trade capacity across the broader region, which is reducing construction wait times compared to the post-COVID backlog that plagued projects in 2022–2023.

Is Dual Occupancy a Good Investment in NSW in 2026?

In short: yes — for the right property at the right price. Dual occupancy in NSW outperforms standard buy-and-hold in 2026 for investors who can access a site with at least 700sqm and side access. Furthermore, the combination of dual rental income and potential strata subdivision adds two distinct exit strategies that a single-dwelling investment simply cannot replicate.

However, the strategy is not risk-free. Crucially, feasibility must stack up at current build costs — not 2021 costs. With construction up 35–45% from pre-pandemic levels, deals that looked viable three years ago may now only break even. As a result, always run updated cost estimates before committing to any site purchase.

My Verdict: DA or CDC — Which Path Should You Choose?

If your site is flat, standard rectangular, in an eligible residential zone, and meets every dimension on paper — choose CDC every time. The 20-business-day turnaround is a genuine competitive advantage. Notably, a CDC start date in January can mean a finished, tenanted second home by December of the same year. Meanwhile, a DA lodged in January may still be in council assessment by December.

By contrast, choose DA when your site has any non-standard characteristic: steep slope, irregular shape, heritage-adjacent location, or a smaller lot. Additionally, if your design adds exceptional value — larger floorplan, premium finishes, distinctive streetscape — the DA process allows those extras to be assessed contextually. If this guide helped you think through your project, check out our Leppington Development Pipeline 2026 article for how this strategy plays out at the corridor scale.

Summary

Overall, dual occupancy Australia 2026 represents a genuine wealth-building opportunity for homeowners and investors who do their homework. However, the strategy requires careful feasibility analysis, the right approval pathway, and realistic cost assumptions. Cutting corners on any of these three fundamentals is the most common reason dual occupancy projects fail to deliver expected returns.

In particular, the battleaxe subdivision format offers exceptional value in suburbs where rear block land is affordable but front-of-street prices are already high. Furthermore, with NSW’s CDC pathway now the fastest complying development approval in Australia, the barrier to getting started is lower than it has ever been. Consequently, 2026 may be the optimal window before further policy changes or construction cost increases narrow the margin.

For detailed planning rules applicable to your project, the NSW Department of Planning publishes the Low Rise Housing Diversity Code and all residential zoning controls. Additionally, always engage a licensed town planner and builder with proven dual occupancy experience before committing to any site purchase.

💡 Related Read: If you are looking for specific high-growth areas for dual occupancy or property investment in Sydney, check out our comprehensive guide on the Leppington Development Projects 2026.
